Full Introduction to Steel Structure Engineering General Contracting

Views: 0     Author: Site Editor     Publish Time: 2026-07-17      Origin: Site

Inquire

facebook sharing button
twitter sharing button
line sharing button
wechat sharing button
linkedin sharing button
pinterest sharing button
whatsapp sharing button
kakao sharing button
snapchat sharing button
telegram sharing button
sharethis sharing button

Steel Structure Construction under a general contracting model is a single-source delivery approach for owners comparing one accountable contractor with separate design, fabrication, and erection vendors. It connects design coordination, detailing, procurement, fabrication, logistics, installation, quality control, and handover. The business problem is usually not steel price alone. It is schedule slippage, design-to-fabrication gaps, cost creep, and unclear responsibility when complex steel packages move from calculations to site work.

The decision lens should cover delivery scope, engineering depth, factory capability, erection planning, compliance, and lifecycle cost. Technical variables such as loads, connections, fabrication sequence, fire protection, coatings, and lifting methods directly affect commercial results. This guide explains how general contracting works across design, procurement, fabrication, logistics, erection, QA/QC, and handover, so bidders can be judged by installed risk rather than headline tonnage. It also sets practical evidence requirements before award for industrial, warehouse, and tall building projects.


Key Takeaways

  • Steel structure construction is fastest and lowest-risk when engineering, detailing, fabrication, and erection are coordinated under one accountable delivery model

  • The right contractor is not just a steel supplier; they need proven steel structure engineering, shop capability, erection planning, and standards-based quality control

  • Cost should be judged by total installed cost and schedule certainty, not only per-ton steel price; connection design, coatings, logistics, crane plans, and rework risk materially change TCO

  • Steel is often the better choice for long spans, industrial buildings, and high-rise steel frame projects, but fire protection, corrosion exposure, and code requirements must be priced honestly upfront

  • A credible bid should prove code compliance, traceable materials, qualified welding and bolting procedures, factory capacity, realistic fabrication lead time, and a clear responsibility matrix


What Steel Structure Construction Includes in a General Contracting Model

What general contracting means in steel structure projects

General contracting in steel structure work means one delivery chain manages the steel package from early definition to final acceptance. The scope may include concept support, structural design coordination, connection design, detailing, procurement, fabrication, transport, erection, inspection support, and handover documentation.

This differs from material-only supply or fabrication-only contracts. Under split procurement, design intent, shop detailing, fabrication sequence, and field erection may sit with different parties. When a connection conflicts with a crane runway, roof opening, or anchor bolt location, responsibility can become disputed. Under an integrated model, the contractor coordinates RFIs, drawing revisions, shop priorities, shipping marks, and site responses through one controlled workflow.

The model is most valuable when the project has compressed dates, heavy trade interfaces, export logistics, phased handover, or limited owner-side steel expertise. It also helps when repeated buildings must carry lessons learned from one phase to the next.

Responsibility matrix for steel structure construction

PartyTypical responsibilitiesRisk if responsibility is unclear

Owner

Defines building use, operating loads, budget, expansion plans, and decision deadlines

Late changes, redesign, and unclear acceptance criteria

Architect

Coordinates layout, clear height, access, envelope, occupancy, and code-driven space needs

Conflicts between usable space and structural efficiency

Structural engineer

Designs framing for safety, stability, serviceability, and code compliance

Unsafe, overbuilt, or difficult-to-erect framing

Steel detailer

Produces shop drawings, connection details, bolt lists, erection drawings, and mark numbers

Fabrication delays, missing parts, and field fit-up failures

Steel structure factory

Procures materials, fabricates members, maintains traceability, applies coatings, and packs by erection zone

Quality variation, coating defects, and disordered delivery

General contractor

Coordinates foundations, cladding, MEP, inspections, safety, RFIs, schedule, and handover

Interface failures between steel and other trades

Erector

Controls lifting, temporary stability, bolting, field welding, alignment, and site safety

Unsafe erection, tolerance failures, and rework

Authority or third-party inspector

Verifies code compliance, special inspections, acceptance records, and closeout documents

Failed inspections, permit issues, and delayed occupancy

Typical project types covered

Integrated steel delivery is common for warehouses, logistics centers, industrial halls, aircraft hangars, sports facilities, and hybrid steel-concrete buildings. It also fits a Steel structure workshop where crane beams, mezzanines, ventilation, process equipment, and expansion bays must be coordinated early.

A Prefabricated steel structure can shorten site duration when repeated bays, standardized members, and clear mark numbering are agreed before fabrication. A High-rise Steel Frame project may benefit from lighter structural weight, rapid tier erection, and ductile seismic behavior, but it requires stronger controls over fireproofing, tolerances, and connections.

When integrated delivery fits, and when it does not

  • It fits projects with aggressive schedules, phased occupancy, or cross-region logistics.

  • It fits buildings where steel, foundations, cladding, cranes, MEP, and fireproofing overlap.

  • It fits owners that need one party to control detailing, fabrication, delivery, and erection sequencing.

  • It may not fit very small buildings where local trade coordination is simple.

  • It may not fit owners that require separate multi-bid procurement at every phase.


Is Steel Structure Construction the Right Structural System for the Project?

Steel structure construction vs reinforced concrete

Steel is often selected for long spans, lighter foundations, faster assembly, future expansion, and better adaptability. Concrete can be stronger commercially where fire resistance, acoustic mass, vibration damping, or local material economics dominate. The correct answer depends on use, loads, code, site access, and lifecycle strategy.

FactorSteel structureReinforced concrete

Weight

Usually much lighter; some comparisons cite suitable steel framing as roughly 60% lighter

Heavier, often increasing foundation reactions

Indicative floor dead load

Often around 60 to 75 psf, depending on system design

Often around 110 to 130 psf, depending on slab and beam design

Span capability

Strong for large grids, clear spans, trusses, and portal frames

Can span well, but may become deeper or heavier

Schedule

Off-site fabrication and fast field assembly can shorten the site critical path

Formwork, staged pours, and curing time can extend sequencing

Seismic behavior

Ductile when designed and detailed under the governing code

Higher mass can increase seismic demand

Fire strategy

Often needs intumescent coating, cementitious fireproofing, encasement, or another approved system

Concrete mass can provide inherent fire resistance

Future changes

Generally easier to modify, reinforce, extend, or partially relocate

Alterations can be more disruptive and labor intensive

Best-fit applications for steel

  • Long-span production halls, logistics centers, warehouses, and workshops needing open space.

  • Industrial buildings where downtime, speed-to-operation, and future line changes affect ROI.

  • High-rise or urban projects where lighter members and faster erection improve access planning.

  • Repeatable prefabricated programs with standardized bays and expansion phases.

  • Buildings using efficient grids, such as approximately 42 ft by 30 ft where engineering validates the layout.

Advantages and limitations owners should price early

CategoryCommercial effectContractor response

High strength-to-weight ratio

Can reduce foundations and support long spans

Validate bay spacing, member sizes, and lateral system early

Factory fabrication

Improves repeatability and inspection access

Use traceable materials, calibrated equipment, and shop QA records

Fire protection

Adds cost, inspection steps, and trade coordination

Define fire rating and compatible systems before final pricing

Corrosion exposure

Raises coating, galvanizing, and maintenance requirements

Classify coastal, chemical, humid, or interior exposure correctly

Buckling and vibration

Can affect comfort, machinery operation, and serviceability

Control bracing, stiffness, deflection limits, and connection detailing


The End-to-End Steel Structure Engineering Process

Front-end definition and feasibility

The front-end stage converts business needs into engineering criteria. The project team should confirm building use, grid, clear height, floor loads, roof loads, crane loads, equipment loads, vibration limits, expansion strategy, access restrictions, and permit route. These items affect tonnage, member selection, foundation reactions, fabrication sequence, and erection method.

Commercial assumptions should also be fixed early. They include target completion date, steel price validity, fabrication slots, coating class, fire rating, export packing, shipping distance, and inspection scope. A design basis memorandum gives bidders the same load assumptions, deflection limits, corrosion class, fire criteria, and code basis.

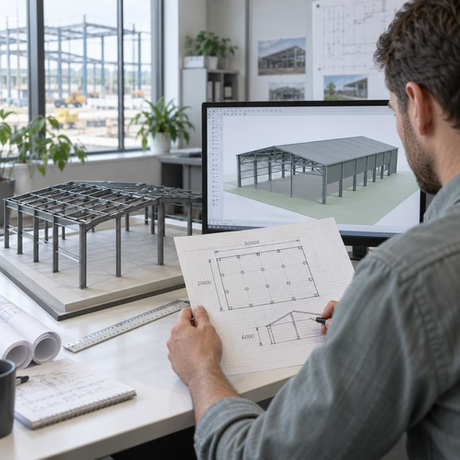

Structural design objectives and workflow

Steel structure engineering is both concept development and member sizing. The engineer must balance strength, stability, serviceability, constructability, inspection access, maintenance, and cost. The workflow should be visible before fabrication release.

  • Confirm occupancy, building use, operational loads, and performance criteria.

  • Develop grid, bay spacing, clear heights, roof slope, and expansion assumptions.

  • Select the primary frame and lateral-resisting system.

  • Define dead, live, roof live, wind, snow, seismic, crane, equipment, and collateral loads.

  • Analyze the structure and complete preliminary member sizing.

  • Design beams, columns, bracing, trusses, girders, base plates, and key secondary members.

  • Design connections and verify shop and field practicality.

  • Check transportation limits, crane access, erection sequence, and fabrication feasibility.

  • Issue calculations, drawings, specifications, and inspection requirements for approval.

Loads, code basis, and design methods

Load definition can change the budget more than a small steel price difference. Dead loads include steel self-weight, decks, roof systems, cladding, ceilings, fireproofing, and fixed equipment. Live loads include occupancy, storage, vehicles, maintenance access, movable equipment, and cranes. Environmental loads include wind, snow, rain, temperature, exposure, and seismic action.

The code basis must be declared before bid comparison. Depending on jurisdiction, common standards include AISC, ASCE/SEI 7, IBC, Eurocode, GB, AWS, RCSC, ASTM, or local equivalents. Where LRFD is adopted, design resistance must exceed factored load effects. Load combinations, resistance factors, serviceability limits, and special inspection rules must come from the governing code.

Structural systems, members, and connections

Braced frames are efficient for many industrial and warehouse buildings. Moment frames preserve open layouts where diagonal bracing is not acceptable. Portal frames, rigid frames, trusses, composite beams, metal deck, and hybrid systems can fit workshops, high-rise projects, and long-span buildings.

Core steel members include tension members, compression members, beams, beam-columns, trusses, girders, purlins, girts, platforms, stairs, ladders, and handrails. Secondary steel still requires coordination because it affects access, MEP routing, shipping marks, and site labor.

Connections deserve early review. Simple bolted shear connections are usually fast to erect. Moment connections transfer bending and shear, so they add fabrication hours, fit-up controls, and inspection steps. Field welding may solve geometry problems, but it can also increase weather risk, access risk, and non-destructive testing requirements.

Bolting, welding, and BIM coordination

  • Common bolt categories include A307 for limited light-duty uses where allowed, plus ASTM F3125 Grade A325 and A490 high-strength bolts.

  • Common installation checks include turn-of-nut, calibrated wrench, twist-off tension-control bolts, and direct tension indicator washers.

  • Common welding processes include SMAW, FCAW, and GMAW/MIG, subject to procedure qualification and site conditions.

  • BIM should coordinate steel with foundations, embeds, anchor bolts, cladding, roof systems, cranes, MEP, stairs, platforms, and fireproofing.

  • Model reviews should resolve clashes, connection congestion, inaccessible welds, coating conflicts, and truck-by-truck shipping sequence.


Steel Structure Factory Capabilities: What to Verify Before Award

Why factory capability matters

A skilled design team cannot fully offset weak fabrication control. Factory capacity affects lead time, dimensional consistency, coating quality, packaging order, and site fit-up. In-house processes also change risk. Outsourced cutting, drilling, galvanizing, or painting can work, but responsibilities and inspection points must be documented.

The contractor should prove that the shop can handle the required member sizes, plate thicknesses, hole tolerances, welding demand, cambering needs, and trial assembly requirements. Complex trusses, heavy nodes, crane beams, and export packages need stronger shop planning than simple columns and rafters.

Minimum fabrication capabilities to assess

  • Plate and section cutting, sawing, drilling, punching, beveling, fitting, assembly, and welding.

  • Hydraulic bending or cambering where preset deflection control is required.

  • Blasting, primer application, painting, fire-resistant coating, and optional galvanizing coordination.

  • CNC equipment and digital production tracking for repeatability and mark control.

  • Material traceability for grades, heat numbers, mill certificates, weld records, and coating batches.

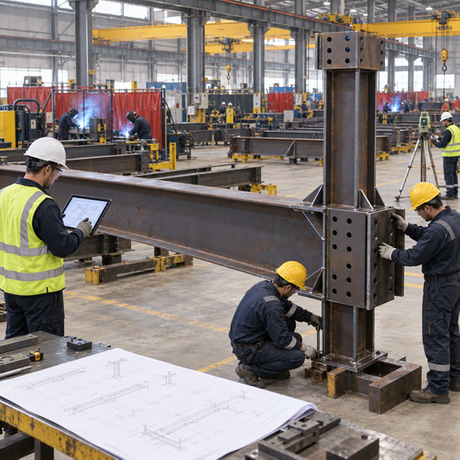

  • Trial assembly capability for complex geometry or long-distance shipment.

  • Packaging systems that match erection zones, lifting order, and truck or container loading.

Typical fabrication workflow and lead time

A standard fabrication flow starts with material procurement and mill certificate verification. It then moves through cutting, hole making, fitting, tack welding, dimensional checks, shop welding, straightening, cambering, grinding, trial assembly where needed, surface preparation, coating, final inspection, marking, packing, and dispatch.

Many building projects fall within an approximate 3 to 8 week fabrication window. The actual duration depends on approval speed, shop utilization, automation, coating system, galvanizing queues, heavy section availability, high-strength bolt procurement, and export packing. Sequencing by erection zone is more useful than planning by total tonnage alone.

Questions to ask before award

  • What is the monthly tonnage capacity, and what is the current utilization?

  • Which processes are in-house, and which are subcontracted?

  • What steel grades, plate thicknesses, and member sizes can the facility process?

  • How are WPS/PQR records, welder qualifications, and calibration logs maintained?

  • Can the factory provide mill certificates, coating records, inspection reports, and shipping lists?

  • Can complex assemblies be trial-fitted before shipment?

  • How are nonconformities documented, corrected, and closed out?


How Steel Structure Construction Is Executed On Site

Pre-erection planning

Site execution starts before steel arrives. Foundations and anchor bolts should be surveyed against approved tolerances. The contractor should confirm haul routes, unloading method, laydown area, crane selection, lift studies, exclusion zones, wind limits, access control, and work-at-height procedures.

Temporary stability planning is necessary because a partially erected frame may not yet have its final lateral strength. The erection method statement should define bracing sequence, bolt-up requirements, release criteria, inspection hold points, and emergency procedures.

Logistics and erection methods

MethodTypical usePlanning concern

Tier erection

Multi-story and high-rise frames progressing floor by floor

Vertical logistics, splice locations, and tolerance stacking

Billboard-style erection

Full-height bays advanced sequentially

Trade access behind completed zones

Modular or preassembled lifts

Repeatable steel packages where crane capacity allows

Lift weight, rigging, temporary bracing, and transport size

Stick-built erection

Constrained sites, lighter members, or smaller projects

Longer field labor and more individual lifts

Erection zones should match crane reach, access roads, laydown space, and follow-on trade sequencing. Shipping by zone helps ensure that the first delivered members are the first required for installation. On suitable projects, a zone may represent several truckloads, sometimes around 10 truckloads where project scale supports it.

Field checkpoints and project-specific issues

Field checks include anchor bolt location, projection, base plate fit-up, column plumbing, frame alignment, bolt installation records, field welding conditions, preheat requirements, and required NDT. Practical column plumbing benchmarks may include horizontal deviation around plus or minus 1 inch or height divided by 500 where the applicable standard and project specification permit.

Workshop and factory buildings need extra attention to crane runway alignment, process platforms, roof penetrations, ventilation equipment, pipe racks, and production-line access. Prefabricated systems depend on accurate foundations, clear mark numbering, and disciplined packaging. High-rise work adds urban staging, fireproofing sequence, facade interfaces, composite deck coordination, wind controls, and public protection.


Quality Control, Compliance, and Inspection Standards

Core standards and inspection roles

A credible contractor should identify the standards governing design, material supply, bolting, welding, coatings, erection, and acceptance. Common references include AISC 360, ASCE/SEI 7, AWS D1.1/D1.1M, RCSC requirements for high-strength bolted joints, ASTM product standards, IBC special inspection provisions, OSHA or local safety rules, and local fire or seismic regulations.

Inspection roles should be named early. Shop inspection, field inspection, welding inspection, bolting inspection, coating inspection, and final acceptance may involve internal QC staff, third-party inspectors, owner representatives, or authority-required special inspectors. Relevant credentials may include AWS Certified Welding Inspector, ICC structural steel and bolting or welding special inspector credentials, or local equivalents.

Shop and field quality controls

Control areaDocuments or checks to request

Materials

Mill certificates, heat-number traceability, grade verification, and receiving inspection records

Dimensional control

Fit-up checks, hole size, spacing, edge distance, alignment, and trial assembly records

Welding

WPS/PQR records, welder qualifications, visual inspection, and specified UT, MT, PT, or RT reports

Bolting

Bolt certificates, installation method, tension verification, and inspection hold points

Coatings

Surface profile, cleanliness, dry film thickness, curing, adhesion, and repair records

Field erection

Anchor surveys, plumbness checks, alignment records, touch-up repairs, and punch-list closeout

Fire protection, corrosion protection, and red flags

Fire rating and corrosion exposure should be confirmed before final pricing and fabrication release. Intumescent coatings, cementitious fireproofing, board systems, encasement, galvanizing, and paint systems have different inspection, repair, appearance, and compatibility requirements. Primer, topcoat, galvanizing, and fireproofing layers should be checked as a complete system.

  • No written inspection and test plan, WPS/PQR records, or inspection matrix.

  • Vague answers on bolting method, weld inspection, tolerances, or field repairs.

  • No material traceability, calibrated equipment records, or qualified welder evidence.

  • Bid exclusions for NDT, coating repair, fireproofing coordination, or special inspections.

  • Frequent reliance on site fixes for avoidable shop errors.


Steel Structure Construction Cost: TCO and ROI Drivers

What actually drives cost

Total cost is driven by steel grade, tonnage, section availability, market price, span length, bay spacing, clear height, lateral system, connection density, coatings, fireproofing, fabrication complexity, transport limits, crane time, safety controls, inspections, and trade interfaces. Local wind, snow, seismic, crane, equipment, and serviceability requirements can materially change member sizes and connection demand.

Lowest per-ton price can be misleading. A low quote may exclude detailing iterations, erection aids, realistic field welding allowances, NDT, special inspections, touch-up painting, fireproofing coordination, or packaging by erection sequence. Lower tonnage is not always cheaper if it requires complex nodes, heavy welding, difficult lifts, or inaccessible inspection points.

ROI drivers that matter to owners

  • Earlier production or occupancy because erection can be faster than concrete-heavy work.

  • Reduced foundation volume where lighter framing lowers reactions.

  • Future expansion through added bays, mezzanines, equipment supports, or modified openings.

  • Lower disruption during production-line changes or building reconfiguration.

  • Reduced site labor on repeatable prefabricated programs when detailing and logistics are controlled.

  • Recyclability, salvage value, or reuse potential where lifecycle planning supports it.

Cost trade-offs by project type

Project typePotential valueCost risk to price honestly

High-rise steel frame

Faster erection, lighter structure, and good seismic behavior

Fireproofing, connection complexity, inspections, and urban logistics

Prefabricated industrial building

Lower site labor and faster assembly

Higher up-front coordination and stricter foundation tolerances

Workshop

Efficient clear spans and future production flexibility

Crane beams, process loads, ventilation penetrations, and platforms

Factory building

Operational flexibility and expansion potential

Equipment loads, corrosion exposure, embedded items, and line access

Hybrid steel-concrete system

Balanced stiffness, speed, fire resistance, and cost

Interface management between trades and structural systems

Bid comparison framework

  • Normalize bids by design basis, code assumptions, loads, deflection limits, fire rating, and corrosion class.

  • Confirm steel grade, coatings, galvanizing, fireproofing, metal deck, shear studs, stairs, handrails, crane beams, and secondary steel.

  • Separate material escalation terms from fabrication labor, erection labor, transport, and crane pricing.

  • Request assumptions, exclusions, alternates, unit rates, and change-order rules.

  • Tie payment to measurable milestones such as design approval, procurement, fabrication, shipment, erection progress, inspection acceptance, and handover.


Implementation Risks and Contractor Shortlisting

Main implementation risks

Technical risks include incomplete loading data, anchor bolt misalignment, connection conflicts, late fire strategy decisions, unresolved vibration issues, corrosion exposure errors, and MEP clashes discovered after fabrication. Field risks include unsuitable crane access, poor laydown planning, weather delays, difficult field welding, temporary stability gaps, and missing inspections.

Commercial risks include steel price volatility, fabrication slot shortages, permit delays, owner changes after shop approval, coating bottlenecks, customs delays, oversize transport restrictions, and unrealistic schedules that ignore RFIs, inspection hold points, and weather downtime.

Risk mitigation and governance after award

  • Require an approved design basis memorandum and a written responsibility matrix.

  • Set BIM clash review, connection review, and shop drawing approval milestones.

  • Maintain a procurement register for heavy sections, custom plates, bolts, coatings, and deck.

  • Complete anchor bolt surveys before steel shipment.

  • Approve factory and site inspection and test plans with witness points.

  • Confirm erection method statements, lift studies, temporary bracing, and safety plans.

  • Track RFIs, submittals, NCRs, shipments, erection progress, inspections, and closeout through a shared dashboard.

Technical, QA, and commercial evaluation criteria

Shortlisting should begin with relevant portfolio evidence. The contractor should show experience with the same building type, span range, tonnage, code basis, wind or seismic category, corrosion exposure, crane loads, and logistics conditions. Engineering depth matters because calculations, connection design, detailing, BIM coordination, and code familiarity directly affect fabrication and erection risk.

Factory capability should be verified through capacity data, equipment lists, quality records, trial assembly examples, coating systems, and traceability procedures. Site capability should be verified through lift studies, sequencing plans, temporary works, tolerance control, safety record, and inspection coordination.

Commercial review should test scope completeness, exclusions, payment milestones, steel price validity, escalation clauses, warranty terms, defect response, and post-handover support. A complete bid should include calculations, shop drawings, erection drawings, mill certificates, WPS/PQRs, welder qualifications, NDT reports, coating records, NCR closeouts, and maintenance recommendations.

Buyer’s decision checklist

  • Engineering scope, code basis, connection responsibility, detailing, and BIM coordination are defined.

  • Wind, snow, seismic, equipment, crane, roof, floor, and serviceability requirements are frozen.

  • Coatings, galvanizing, fireproofing, inspection, temporary works, delivery, unloading, and erection are included or clearly excluded.

  • Foundation tolerances, anchor bolt requirements, cladding interfaces, MEP penetrations, and roof openings are coordinated.

  • Factory capacity, fabrication lead time, shipping sequence, and mark numbering are verified.

  • Total installed cost is compared instead of per-ton steel price alone.


Conclusion

Steel structure general contracting creates value when speed, span efficiency, seismic performance, and future adaptability matter. Project owners should move forward only when the contractor can prove accountable engineering, traceable fabrication, realistic erection planning, and standards-based inspection.

  • Freeze the design basis, loading criteria, code assumptions, fire rating, and corrosion class.

  • Issue a normalized RFQ with a responsibility matrix and clear exclusions schedule.

  • Audit the factory and review sample calculations, shop drawings, QA records, and coating documents.

  • Validate fabrication lead time, shipping sequence, crane plan, and erection method statement.

  • Award based on risk-adjusted installed value, not headline tonnage or per-ton price.


FAQ

Q: What is included in steel structure construction under a general contracting scope?

A: It commonly includes design coordination, structural analysis support, detailing, material procurement, fabrication, logistics, erection, inspection support, and handover records. Foundations, cladding, MEP, fireproofing, cranes, or galvanizing may be separate unless the contract includes them. A written responsibility matrix should define every interface.

Q: Is steel structure construction cheaper than concrete?

A: Not always. Steel is often faster and lighter, which can reduce foundations and site labor. Final cost depends on spans, fire rating, corrosion exposure, local pricing, inspection scope, and erection complexity. The fair comparison is total installed cost, schedule value, lifecycle maintenance, and future expansion flexibility.

Q: How long does a steel structure project usually take?

A: Timing depends on design approval, plant capacity, fabrication complexity, coating scope, shipping distance, and erection method. Fabrication for many standard building packages may fall within roughly 3 to 8 weeks. Complex structures can take longer, so the full design-to-handover schedule should control planning.

Q: What standards should a steel structure engineering contractor follow?

A: The governing standards depend on jurisdiction. Common references include AISC, ASCE/SEI 7, AWS D1.1, RCSC, ASTM, IBC, OSHA, and local building, fire, seismic, coating, and safety codes. Bidders should state which standards govern design, welding, bolting, erection, inspection, and acceptance.

Q: What is the difference between a steel structure factory and a steel structure workshop project?

A: A steel structure factory may mean the fabrication facility that produces steel members. A steel structure workshop usually means the end-use industrial building for manufacturing, repair, assembly, or production. Contractor evaluation should check both shop fabrication capability and project experience with completed workshop buildings.

Q: When is a prefabricated steel structure the best option?

A: It is usually best when speed, repeatability, and lower site labor are priorities. It fits standardized bays, warehouses, workshops, logistics centers, and expansion programs. It also requires accurate foundations, coordinated shop drawings, disciplined mark numbering, and shipping sequences matched to erection zones.

Q: What are the biggest risks in high-rise steel frame construction?

A: Main risks include connection complexity, tolerance accumulation, fireproofing coordination, urban staging, crane planning, temporary stability, and public protection. They are manageable when BIM coordination, factory quality control, special inspections, lift planning, and multi-trade sequencing are completed before field erection accelerates.

Quick Links

Products

Contact Us

 Telephone: +86-151-2258-2058
 WhatsApp:  +8615122582058
 Email: sales@zsjhsteelgroup.com
 Address: No. 1 11th Meridian Road, Industrial Zone, Dakoutun Town, Baodi District, Tianjin, China
Copyright © 2026 Zhong Sheng Jia He Construction Engineering (Tianjin) Co., Ltd. All Rights Reserved. Sitemap | Privacy Policy
